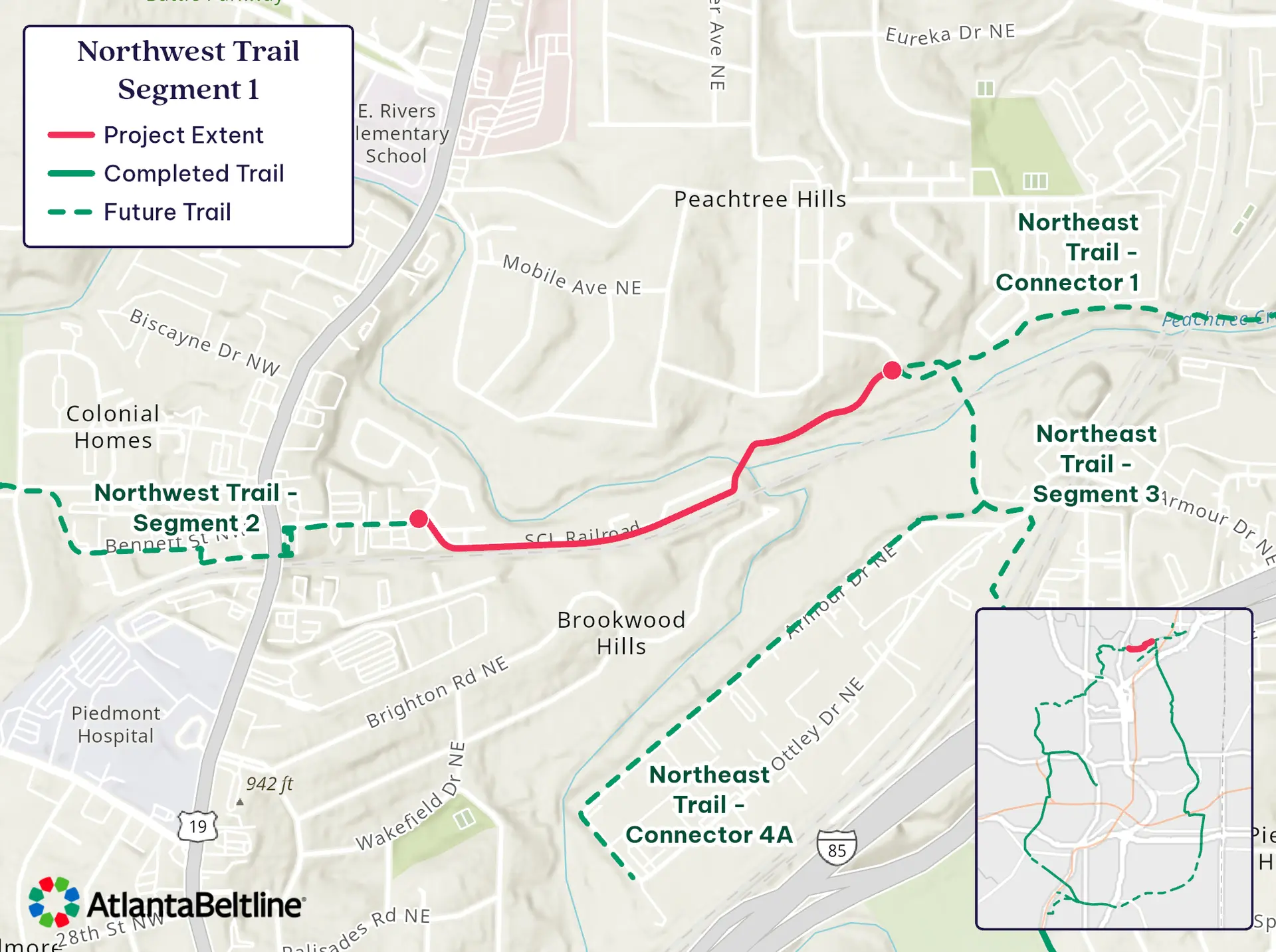

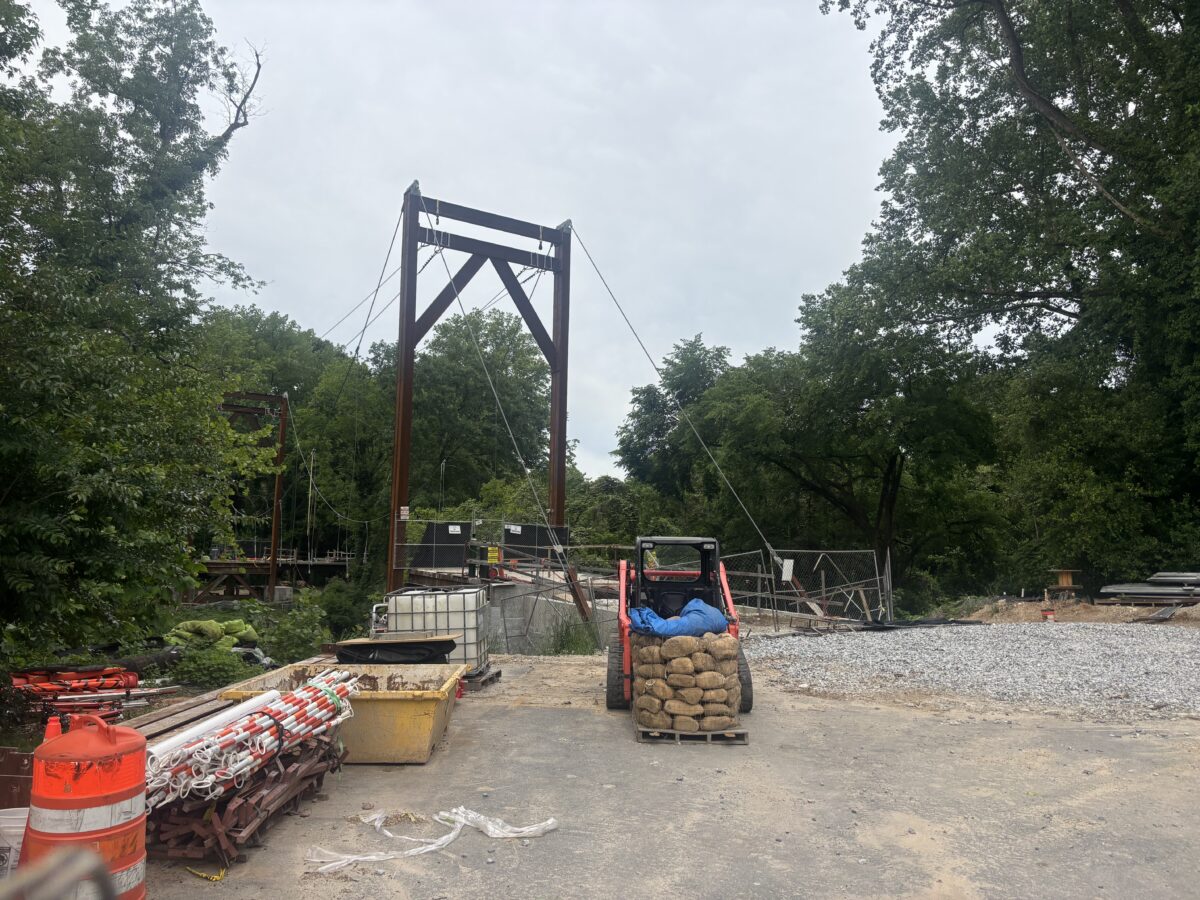

The Atlanta BeltLine Northwest Trail, Segment 1, spans 0.8 miles from the western edge of Peachtree Park Apartments to Kinsey Court and runs south across Peachtree Creek. This is a critical segment of the BeltLine that will connect Buckhead’s existing BeltLine segment that loops around Bobby Jones Golf Course and Memorial Park to Piedmont Park, Ponce City Market, and beyond. After breaking ground in late October 2024, construction ran smoothly until early this spring, when the hired contractor, Reeves Young, began disassembling the nearly complete suspension bridge. According to Kim Wilson, Atlanta BeltLine’s Vice President of Design & Construction, the disassembly began “following an issue that arose during a concrete deck pour. An independent engineering review identified matters requiring further evaluation and corrective action by the contractor.”
The Invisible Failures and Why the Bridge Came Down

An independent evaluation conducted by engineering firm TYLin in October 2025 details structural deficiencies that rendered the $3.6 million bridge unsafe for public use:
- Pylon Instability: During the initial concrete pour, the North Pylon deflected 19 inches toward the river. This was caused by backstays, operating at 1.7 times their intended capacity.
- Foundation & Scour Risks: The helical pile foundations were found insufficient to withstand “scour” (erosion) from a 100-year flood event, which would likely cause the piles to buckle or be undermined.
- Widespread Code Non-Compliance: Multiple primary components failed to meet AASHTO safety standards. The tower columns, in their as-built state, were found to be at nearly double their flexural capacity.
- The “Vibration” Factor: The bridge failed comfort criteria for pedestrian movement. While a single walker caused noticeable swaying, the report estimated that just 5 people walking in sync could reach the maximum allowable acceleration limit for the structure.
Financial Accountability
As disassembly began in early spring 2026, questions surfaced regarding who would foot the bill for the “do-over”. The answer lies in the fine print of the contract between ABI and Reeves Young, LLC. The project is governed by a Construction Manager at Risk (CMAR) agreement with a Guaranteed Maximum Price (GMP) of $23,916,713.09 for the entire .8-mile segment 1 trail section. A review of the construction contract indicates that the amount allocated specifically towards the cost of the bridge is just shy of 3.6 million dollars. Under this “at-risk” model, the contractor guarantees that the cost of the work will not exceed the GMP. Notably, ABI’s legal counsel confirmed on May 13, 2026, that there are no change orders related to the disassembly or reconstruction of the bridge. This indicates that Reeves Young may be contractually obligated to absorb the costs of the failure rather than passing them on to taxpayers.
A “Learning Curve” in Public View

When asked about the effects on the greater community, Wilson responded, “We have shared updates during recent community meetings to keep neighbors informed. We remain committed to delivering the Northwest Trail safely, efficiently, and transparently, and we appreciate the community’s patience as work continues.”
In the BeltLine’s first quarterly briefing of 2026, on March 5th, 2026, representatives of The Atlanta BeltLine stated, “Northwest Trail segment 1. This is over by Peachtree Creek. Construction is ongoing and should be completed by Q4 of next year.”
While the trail segment south of the creek is expected to open for residents of the Peachtree Park Apartments this spring, the bridge itself remains the project’s primary bottleneck. Reassembly is currently on hold to allow for crane access, with the total project completion now pushed back to late 2027 or early 2028.
For a community that has eagerly anticipated the Atlanta BeltLine’s full vision to take shape, “patience” is a word Buckhead locals know all too well. Whether that patience will once again be rewarded — and on schedule this time — remains to be seen.
Contractor, Reeves Young, has been contacted regarding this issue, but has declined to comment.
For Buckhead residents, the wait for a continuous BeltLine connection to Piedmont Park continues. Stay tuned to Buckhead.com for updates as we pursue additional information on the replacement bridge design and installation.
